How long does a HubSpot implementation actually take?

By Sheila Ghamkhar

How long does a HubSpot implementation actually take?

A proper HubSpot implementation for a mid-to-large B2B company takes three to six months from kickoff to full go-live. If you've started asking partners for timelines, you've probably heard "six weeks" more than once. The truth is more useful than that. What happens during those months matters more than the number itself, and understanding it will help you avoid the most common implementation mistakes.

HubSpot implementation timeline at a glance

  • A typical HubSpot implementation for a mid-to-large B2B company takes 3–6 months.
  • The timeline includes strategy, configuration, integrations, data migration, training, and adoption support.
  • The most common causes of delay are unclear ownership, poor data quality, scope changes, and slow stakeholder approvals.
  • Multi-country or multi-language implementations typically require an additional 4–6 weeks.
  • A successful implementation aims for long-term adoption and team self-sufficiency, not just a fast go-live.

What is a HubSpot implementation?

A HubSpot implementation is the process of designing, configuring, integrating, populating, and adopting HubSpot across marketing, sales, and service teams. A successful implementation includes both technical setup and organisational change.

Three to six months is not a limitation. It's what separates a CRM your team will genuinely own and use from one that quietly becomes shelfware within a year.

Here's what that timeline actually contains.

Why rushed go-lives fail

The implementations that go wrong almost always share one thing: they skipped the thinking and went straight to the clicking.

When teams go live on an under-configured HubSpot before they've agreed on lifecycle stages, defined what a "qualified lead" means, or resolved which data from the old system to migrate, the platform inherits all the confusion of the processes it was meant to fix.

A rushed implementation typically leads to:

  • Lower user adoption due to unclear processes.
  • Poor reporting due to inconsistent lifecycle stages and definitions.
  • Reduced trust in CRM data because migration issues were not resolved.
  • More rework after launch because decisions were deferred rather than made upfront.

Low adoption, poor data quality, and a tool that sits unused within twelve months: these aren't HubSpot problems. There are implementation problems. The six-week timeline is almost always where they start.

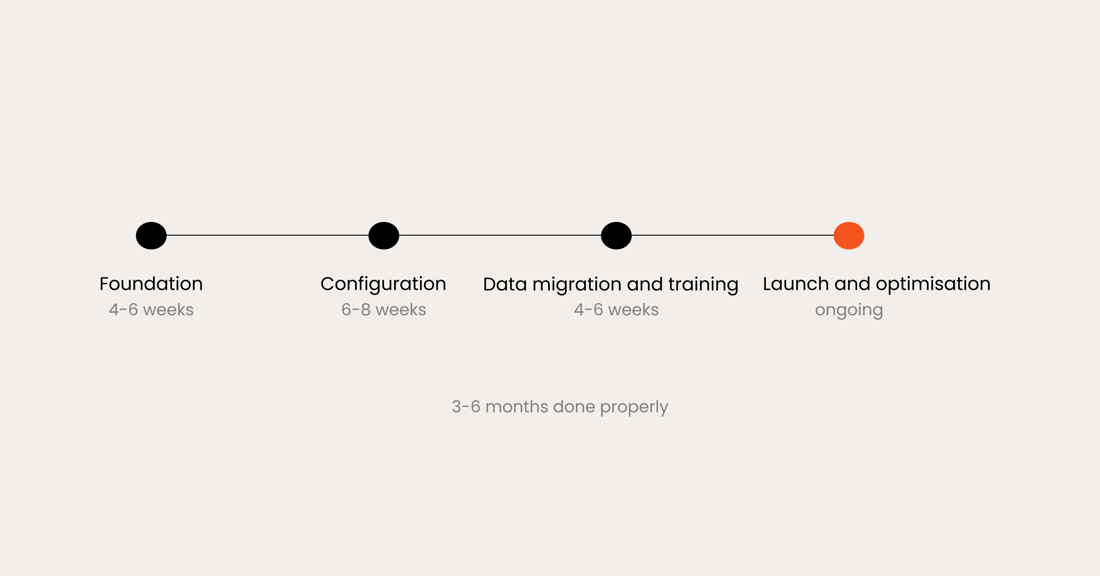

The four phases of a Zooma HubSpot implementation

Phase 1: Foundation (4–6 weeks)

Before a single field is configured, we align your team on strategy and design the CRM architecture that everything else will be built on. This is where most implementation failures originate. Not in the technical execution, but in the absence of a shared understanding of what "good" looks like before work begins.

In Phase 1, we define contact definitions, lifecycle stages, deal pipeline structure, and the KPIs that will govern what follows. It sounds like planning. It is planned. And skipping it costs far more in rework than it saves in speed.

Phase 2: Configuration and integration (6–8 weeks)

With the foundation agreed, we configure HubSpot to your specific B2B processes: marketing workflows, sales sequences, service pipelines, and the integrations your business depends on, including ERP, finance systems, and data enrichment tools. This is where generic HubSpot becomes your HubSpot.

Phase 3: Data migration and training (4–6 weeks)

Data migration is consistently the most underestimated part of a HubSpot project. We run parallel validation rather than a single bulk import, so that what arrives in HubSpot on go-live day is clean, structured, and trustworthy.

Training in this phase is role-specific. A sales rep, a marketing manager, and a service team leader need completely different things from the platform. A one-size-fits-all walkthrough serves none of them well.

When Interwheel, a tyre and wheel supplier based outside Gothenburg, went through this phase, their Sales and Marketing Director, Karl Helmer, described the experience this way:

"The process of planning the full project, from system to people, was very clear and systematic, which gave us full confidence going into the implementation phase. The onboarding of our teams was outstanding, structured, logical, involving (for all levels of experience) and fun."

– Karl Helmer, Interwheel

Read the full Interwheel case →

Phase 4: Launch and optimisation (ongoing)

Go-live is the beginning, not the end. We implement usage dashboards so leadership can track adoption in real time, and we coach teams through the first 90 days when habits are being formed. Our target, which we measure explicitly, is 70–80% team self-sufficiency within 6–9 months of go-live. The goal is for your team to own HubSpot independently, not to create a dependency on us.

What actually slows implementations down

Based on Zooma's work across manufacturing, industrial tech, professional services, and energy sectors, these are the most common causes of delay.

Unclear internal ownership.

If there's no single accountable person on the client side, every decision slows down. This is the single biggest factor affecting speed across all the projects we've run.

Data that's more complex than anticipated.

Legacy CRM data, duplicate records, or inconsistent field structures across regions tend to surface in Phase 1 if you look for them, and mid-project if you don't.

Scope expansion mid-project.

Adding integrations or requirements after Phase 1 is agreed is the fastest way to push go-live back.

Slow stakeholder sign-off.

Particularly common in companies with long internal approval chains.

None of these is insurmountable. They're manageable when identified upfront, which is exactly why the Foundation phase precedes any configuration.

What a well-executed implementation looks like in practice

Mölndal Energi, a renewable energy supplier serving over 70,000 households and businesses in the Gothenburg region, migrated its entire sales and service operation to HubSpot with Zooma. Today, everything from a customer's first conversion to their latest support request is logged, delegated, and handled within HubSpot. In 2023, their customers gave an average satisfaction score of 9.6/10.

Read the full Mölndal Energi case →

At Interwheel, the project involved more than 100 participants from both organisations. A year after go-live, KPIs were met, and user NPS had climbed more than 60 points. Alireza Abbasi, who led the marketing side of the implementation, put it plainly:

"One of the main reasons for this successful implementation is Zooma. Because Zooma can understand the business needs and has a structured way of working."

– Alireza Abbasi, Interwheel

Multi-market and European implementations

For B2B companies operating across multiple countries or regions, add 4–6 weeks to the baseline timeline. Multi-currency, multi-language, and GDPR-compliant configurations for European operations require additional setup and validation.

Zooma has particular depth in Nordic and pan-European implementations, including Schrems II compliance and regional data processing requirements.

The questions worth asking before you start

Before evaluating any implementation partner, it's worth being clear on a few things internally:

  • Who will own this project on your side, and do they have the authority to make decisions?
  • How clean is your current data, and where does it live?
  • What does your team actually need HubSpot to do, and have sales, marketing, and service aligned on that?

The answers will tell you a lot about how smooth your implementation is likely to be, regardless of which partner you choose.

Ready to see what this looks like for your business?

Zooma has been a HubSpot partner since 2012. Our HubSpot services cover everything from initial architecture through seamless data migration to long-term adoption support.

FAQ

Can HubSpot be implemented in six weeks?

Yes, but typically only for smaller or less complex implementations with limited integrations, clean data, and a narrow project scope.

What phase usually takes the longest?

Configuration, integration, and data migration typically consume the largest share of implementation time because they involve both technical work and business validation.

What causes the biggest implementation delays?

The most common causes are unclear ownership, poor data quality, scope expansion, and slow stakeholder approvals.

How long does adoption take after go-live?

Most organisations require 6–9 months after launch to achieve high levels of team self-sufficiency and consistent platform usage.

Sheila Ghamkar has been a core part of Zooma's project manager team since joining in 2024. Before becoming a Zoomer, she worked in marketing in a range of companies across industries, and has an educational background in business administration and economics, focusing on strategy and marketing. Whether it's a small tweak to a customer's online presence or a full-on launch, Sheila holds the projects together with confidence and expertise. Outside of work, she spends a lot of time in the kitchen and likes to inspire the other Zoomers with her latest recipe tips.
